USS Theodore Roosevelt Headed Into Mid-Life Overhaul
Related Stories: Americas - USA, Contracts - Awards, Engines & Propulsion - Naval, Northrop-Grumman, Support & Maintenance, Surface Ships - Combat
The USS Theodore Roosevelt [CVN 71] was built by Northrop Grumman’s Newport News sector. Commissioned on October 25, 1986, CVN 71 is expected to remain in service until 2036. As it approaches its mid-life stage, however, the wear begins to show. Instead of putting a ramp on its flight deck, buying it a nice red car, and pairing it with much younger ships, the US government has begun preparing instead for the refueling and complex overhaul (RCOH) of CVN 71 and its reactor plants.
The USS Theodore Roosevelt is scheduled to arrive at the Newport News shipyard in August 2009 to begin its RCOH, and Northrop Grumman has valued the planning phase alone at $558 million. So what exactly is a RCOH, and how expensive is it likely to get before all is said and done?
The RCOH Process

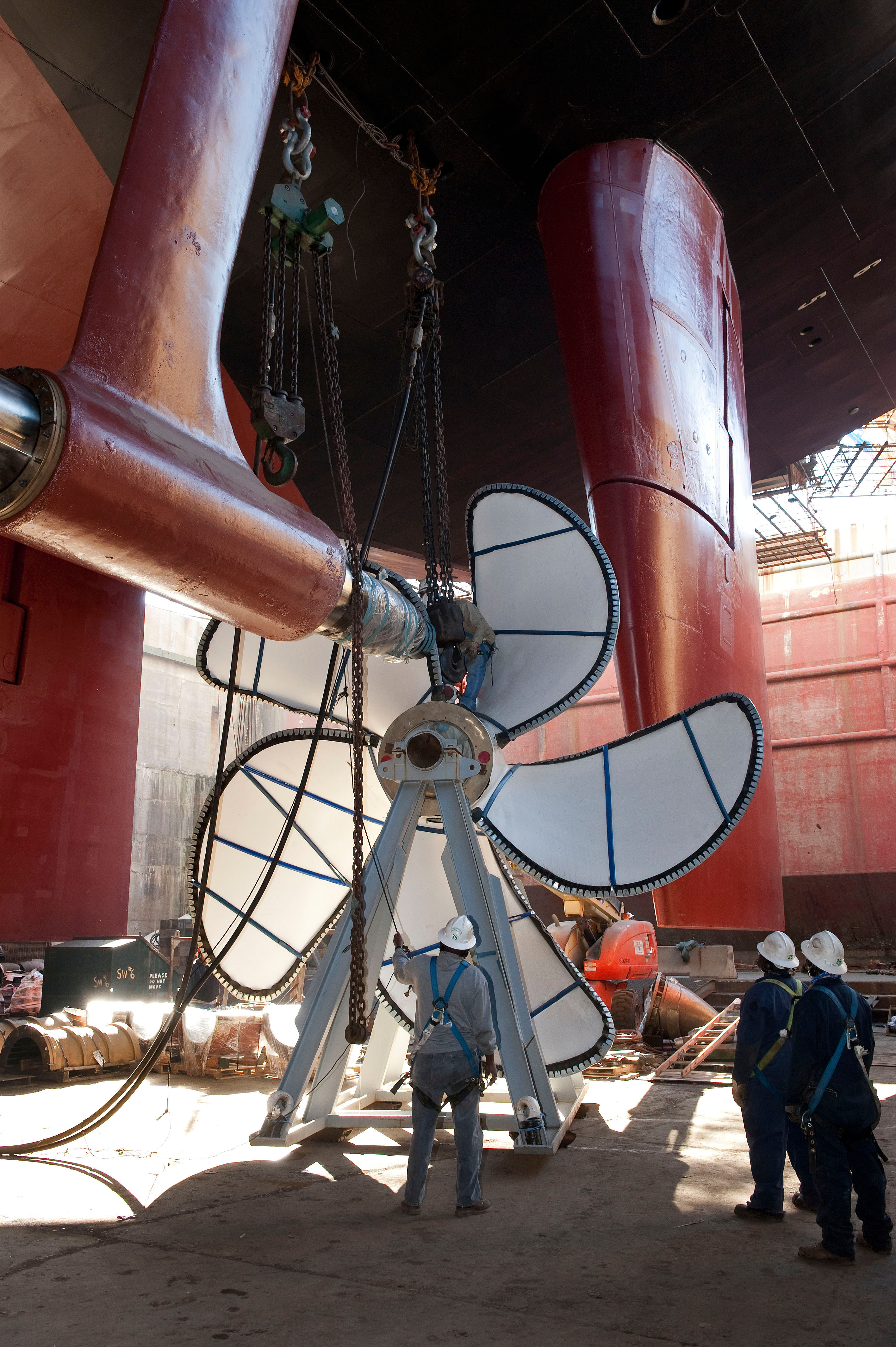

After nearly 25 years of service, the USA’s nuclear aircraft carriers undergo a 3-year maintenance period to refuel their nuclear reactors, upgrade and modernize combat and communication systems, and overhaul the ship’s hull, mechanical and electrical systems. This is the refueling and complex overhaul.
During an American Nimitz Class carrier’s 50 year life span, it has 4 Drydocking Planned Incremental Availabilities and 12 Planned incremental availabilities. It has only one RCOH, however, which is the most significant overhaul the ship receives during its 50-year life span. See DID’s November 2005 coverage and detailing re: the CVN 70 USS Carl Vinson’s RCOH, which is expected to cost a total of $3.1 billion; about $1.94 billion went to Northrop Grumman for planning and execution.
Note that the new CVN-21 Gerald R. Ford Class will have a redesigned nuclear power plant whose features will affect its RCOH. The new system is expected to make use of advances from the USA’s Seawolf and Virginia Class submarine reactors, in order to eliminate expensive reactor refueling completely, increase the reactors’ output, and drop the number of people required to operate them.
The Nimitz Class isn’t so lucky – hence ongoing RCOH efforts and contracts involving CVN 71.
Contracts & Key Events
Unless otherwise specified, all contracts are issued to Northrop Grumman’s Newport News in Newport News, VA by the Naval Sea Systems Command in Washington, DC.
Aug 26/09: A $2.4 billion cost-plus-incentive-fee contract for Refueling Complex Overhaul of the USS Theodore Roosevelt [CVN 71]. The work will include the refueling of the ship’s reactors, as well as extensive modernization work to more than 2,300 compartments, 600 tanks, and hundreds of systems. In addition, upgrades will be made to the flight deck, catapults, combat systems and the island. Northrop Grumman expects to complete the RCOH work by February 2013. This contract was not competitively procured (N00024-09-C-2107).
Dec 12/08: Weapons upgrade. Raytheon Integrated Defense Systems in Portsmouth, RI receives an $11.8 million modification to a previously awarded contract (N00024-06-C-5422), exercising the FY 2009 NATO SEASPARROW Program Office’s FY 2009 options.
Under this order, the USS Theodore Roosevelt will receive 2 MK29 MOD 4 ESSM ORDALT Kits, and 4 Solid State Transmitter (SSTX) MK73 MOD 3 ORDALT Kits. ORDnance ALTeration kits allow ships to swap out their older RIM-7 Sea Sparrow air defense missile systems for the RIM-162 ESSM, which is designed to deal with modern anti-ship missiles.
This particular order also includes 2 more MK29 MOD 4 ESSM ORDALT Kits for use on LHD ships. This modification is a follow-on effort, which was previously performed under contract N00024-02-C-5421. Work will be performed in Portsmouth, RI and is expected to be complete by October 2010. The NATO SEASPARROW consortium, which includes the United States and 12 other countries, will fund this modification.
Oct 27/08: A $300.7 million cost plus fixed fee contract for continuation of the USS Theodore Roosevelt [CVN 71] Refueling Complex Overhaul advance planning efforts. This involves advance planning, ship checks, design, documentation, engineering, procurement, fabrication and preliminary shipyard or support facility work to prepare for the RCOH. Work will be performed in Newport News, VA This contract was not competitively procured (N00024-07-C-2117).
Oct 24/07: A $190.7 million cost-plus-fixed-fee (with performance incentives) option to previously awarded contract (N00024-07-C-2117) for continuation of the USS Theodore Roosevelt [CVN 71] Refueling Complex Overhaul advance planning efforts.
This option will continue to provide for advanced planning, shipchecks, design, documentation, engineering, procurement, fabrication and preliminary shipyard or support facility work to prepare for and make ready for the refueling, overhaul, modernization and routine work on CVN 71 and its reactor plants. Work will be performed in Newport News, VA and is expected to be completed by October 2008. See also NGC release, which sets the total estimated value of the contract at $558.2 million.
Nov 16/06: A $65.3 million cost-plus-fixed fee, level of effort contract for FY 2007 advance planning in preparation for the refueling and complex overhaul (RCOH) of the USS Theodore Roosevelt (CVN 71) and its reactor plants. Northrop Grumman’s Newport News will perform the advance planning, design, documentation, engineering, material procurement, shipboard inspections, fabrication, and preliminary shipyard or support facility work. This contract was not competitively procured (N00024-07-C-2117).
