USCG’s Sentinel-class Fast Response Cutters – Not Fast Enough?
The USCG wants to buy 58 Fast Response Cutters (FRC), and these Sentinel Class boats are sorely needed by an overstretched US Coast Guard. An attempt to extend the lives of their aged Island Class cutters ended as an expensive failure in 2005, and string of blunders has delayed replacements. In February 2006, the Coast Guard’s Deepwater system-of-systems program ‘temporarily’ suspended design work on the FRC-A program due to technical risk. FRC-A was eventually canceled in favor of an off-the-shelf buy (FRC-B), and on March 14/07, the ICGS contractor consortium lost responsibility for the Deepwater FRC-B program as well. By then, even an off-the-shelf buy couldn’t get the Coast Guard any delivered replacements before April 2012.
When the Island Class refurbishment program was terminated in June 2005, 41 Island Class vessels like the USCGC Sanibel, above, still plied US and international waters. DID discusses the programs, their outcomes and controversies, the fate of the Island Class and FRC-A programs, and the work underway to replace them. The Island Class’ safe lifetime is running out fast, but by the end of 2013 FRC Sentinel Class deliveries were set to ramp up to full production pace. Will that be fast enough?
Behind the Programs: The Modernization Imperative
It has been clear for some time that the US Coast Guard needed a massive modernization effort, after years of neglect. In his February 14/07 statement to Congress, Adm. Allen said:
“By the mid 1990s, most of our ships and aircraft were approaching the end of their service lives. Our cutter fleet was then, and remains, one of the oldest among the world’s naval fleets. In light of a looming block fleet obsolescence, it wasn’t sensible to attempt piecemeal, one-for-one replacement of each class of assets. We also didn’t have the capacity to manage that many projects in parallel.”
The US Department of Homeland Security’s Inspector General agreed with Adm. Allen’s assessment. His report showed that out of 39 similar naval organizations surveyed, only 2 countries had fleets older than the United States Coast Guard. One of those countries was North Korea.
Former Commandant Collins had been sounding this clarion call throughout his 4-year stint, and elected representatives had been paying attention. In a July 2004 newsletter to her constituents, Nat Helms reports that Senator Olympia Snowe [R-ME] explained what Congress had done to help the Coast Guard improve itself in 2004:
“In the final hours of Congress’ legislative session this July, the Coast Guard Authorization conference report unanimously passed both the House of Representatives and the Senate. What is impressive is that it authorized $5.4 billion in operational funding for fiscal year 2005, a 14 percent increase over last year’s appropriation. Included in that funding is $1.1 billion to modernize the Coast Guard’s fleet under the Integrated Deepwater Systems – a major recapitalization of ships and aircraft required to operate in “blue water,” which is located more than 50 miles off shore. With this authorization, the Deepwater project will now be on a 10-year modernization time line, which could save the Coast Guard $4 billion and provide an added 943,000 additional and more capable mission hours over the 20-year plan.”

The program has not gone as planned. Just over a year after the Coast Guard’s record of excellent performance during Hurricane Katrina’s aftermath had firmed up Congressional support for the service and its modernization program, the Coast Guard and the Deepwater program have found themselves under sustained fire. A positive GAO report on the overall program in June 2006 was followed by December 2006 revelations that stretched beyond the Island Class and Fast Response cutters. Many of these revelations came courtesy of former Lockheed Martin employee Mike DeKort, who had hammered on his superiors without success to address obvious problems – like onboard equipment that couldn’t handle a maritime environment.
This article will focus on two interlinked aspects of that program, neither of which has gone as planned or fulfilled their initial hopes: the failed modernization of the USCG’s 49 Island Class cutters, and the Fast Response Cutters that are intended to replace them.
FRC Plan B: The Sentinel Class
Appendix B details the failure of the initial FRC program, which aimed to field a composite-hull cutter to replace the Island Class. That forced an end to the contractor-managed effort, and the subsequent breakup of the Deepwater Lead System Integrator model brought the next steps under the sole control of the US Coast Guard.
The eventual winner of the FRC-B competition to field the USCG’s Sentinel Class cutter was Bollinger Shipyards, with a design based on the Damen of the Netherlands’ proven Stan patrol 4708 design. Bollinger’s partnership already had a successful history behind it: their Marine Protector Class Patrol Boats, which are currently being delivered to the Coast Guard, are also based on a Damen parent craft.

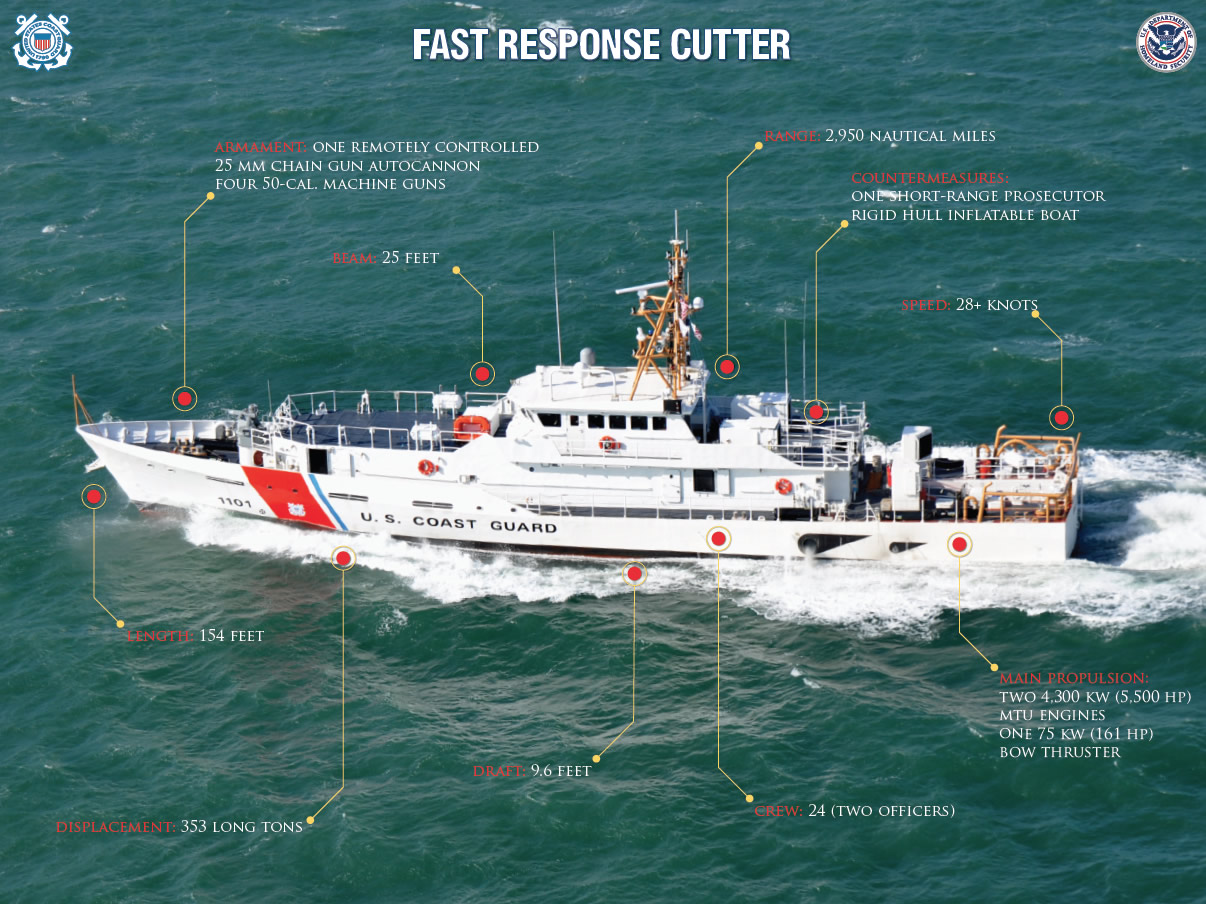

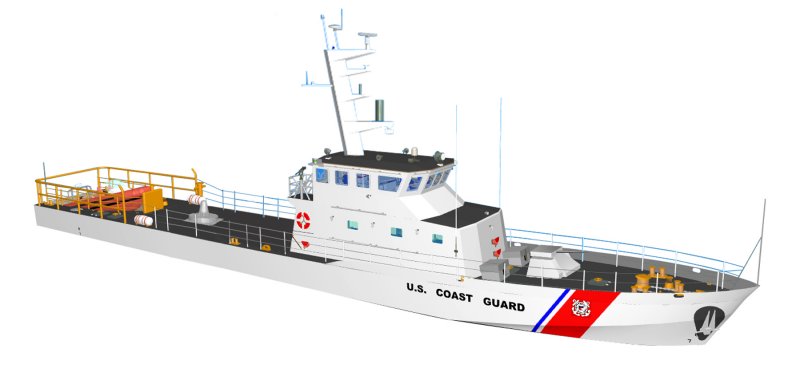

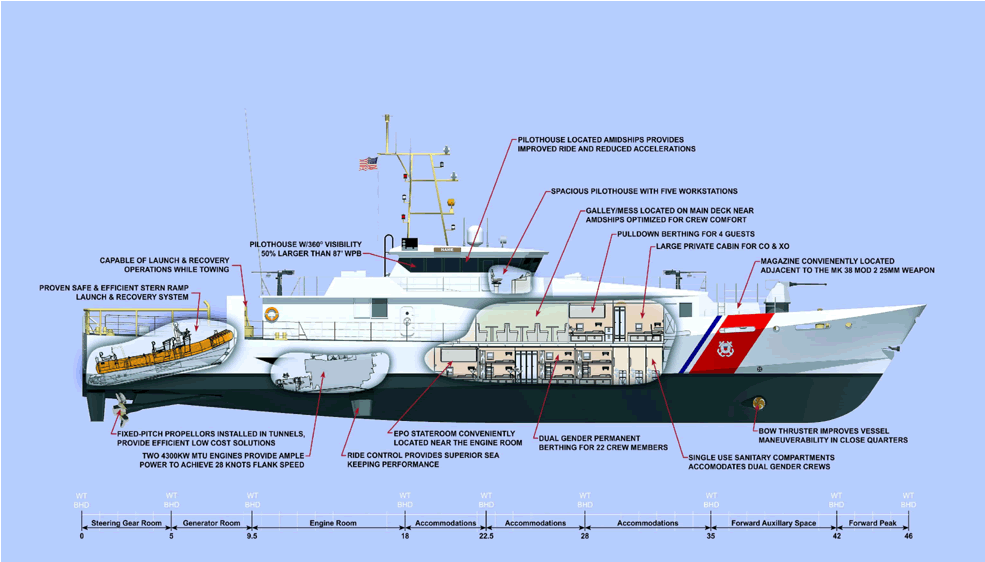

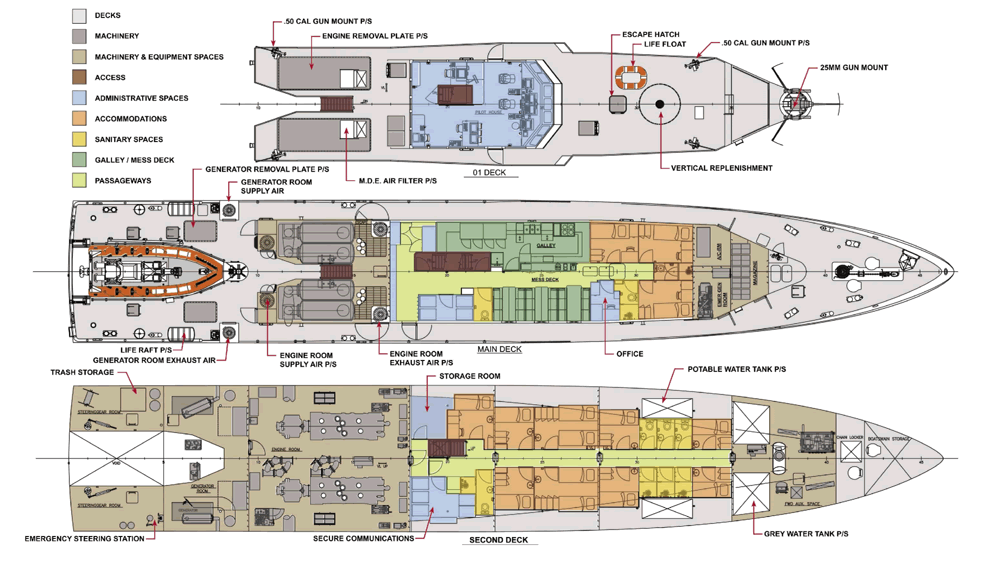

The USCG’s Sentinel Class cutters will be 153 feet long, with a 25′ 5″ beam and an 8′ 5″ draught. They will be armed with a Mk38 MOD 2 stabilized, remotely-operated 25mm chain gun that can fire accurately from a pitching ship, and 4 crew-served .50-caliber machine guns. The ships will be powered by 2 TIER II diesel engines rated at 5,760 bhp, driving fixed rather than controllable-pitch propellers. This saves weight & complexity, and improves top speed from 23.8 to over 28 knots.
The Sentinel Class will be built to ABS High-Speed Naval Craft Guide specifications, which has meant adding watertight bulkheads. Other modifications from the original Damen design include stern launch facilities for a rigid hulled inflatable boat, an electrical system that offers North American voltages, and a reconfigured interior.
The boats and their crews of 22-24 personnel are clearly intended for near-shore activities. The design’s base endurance at sea with full crew is just 5 days, but they can sortie often, giving them the ability to be underway for 2,500 hours per year. Like their fellow Deepwater cutters, FRCs will carry a subset of the Deepwater C4ISR (command, control, communications, computer, intelligence, surveillance, and reconnaissance) system.
A $1.5 billion contract for the Sentinel Class design/data package, and up to 34 Sentinel Class cutters, was issued in September 2008. It remains to be seen whether the 24 ships of the follow-on FRC Phase II buy will stay with the Damen design, or field a different design that meets FRC requirements. The Initial 2011 RFI leaves both possibilities open.
All of these boats will be named after enlisted Coast Guard heroes, who distinguished themselves in USCG or military service. The first 25 have been named, but only 8 have been commissioned:
- CGC Bernard C. Webber, WPC 1101
- CGC Richard Etheridge, WPC 1102
- CGC William Flores, WPC 1103
- CGC Robert Yered, WPC 1104
- CGC Margaret Norvell, WPC 1005
- CGC Paul Clark, WPC 1106
- CGC Charles David Jr., WPC 1107
- CGC Charles Sexton, WPC 1108
- CGC Kathleen Moore, WPC 1109
- Raymond Evans (1110)
- William Trump
- Isaac Mayo
- Richard Dixon
- Heriberto Hernandez
- Joseph Napier (1115)
- Winslow W. Griesser
- Richard H. Patterson
- Joseph Tezanos
- Rollin A. Fritch
- Lawrence O. Lawson (1120)
- John F. McCormick
- Bailey T. Barco
- Benjamin B. Dailey
- Donald H. Horsley
- Jacob L. A. Poroo (1125)
The Coast Guard sees the Caribbean and the Gulf of Mexico as its top priorities, and has sent the first Sentinel Class cutters to those regions. The first 6 FRCs were delivered to Miami, FL, and the next 6 are being homeported at Key West, FL. Boats 13-18 are slated for San Juan, Puerto Rico, and boats 19-20 will be based in Pascagoula, MS. Ketchikan, AK will get boats 21-22. Subsequent boats haven’t been assigned, but they will be distributed among Honolulu, HI (2); Portland, ME (2); Atlantic Beach, NC (2); Cape May, NJ (2); and San Diego, CA (4).
FRC-B: Contracts & Key Events
FY 2014
Commissioned: 7-8; Budgets & retirements creating a numbers problem.
July 23/14: +6. Bollinger Shipyards of Lockport, LA receives a 255.1 million contract option for 6 more Sentinel Class Fast Response Cutters (FRCs) and 3 sets of deep insurance spares.
This option brings the total number of FRCs under contract with Bollinger to 30, with 10 delivered so far, and the total value of the contract to nearly $1.38 billion. Nine FRCs have been commissioned into service, and the Raymond Evans, will be commissioned this September in Key West, FL. Sources: USCG, “Acquisition Update: Contract Option Exercised for Six Fast Response Cutters”.
6 FRCs, to 30
June 26/14: #10. The Coast Guard accepts delivery of Coast Guard Cutter Raymond Evans, the 10th FRC ship. The commissioning ceremony will take place in Key West, FL on Sept 6/14 Sources: USCG, “Acquisition Update: Tenth Fast Response Cutter Delivered to the Coast Guard.”
May 10/14: CGC. Coast Guard Cutter Kathleen Moore [WPC 1109] is commissioned into service at Coast Guard Sector Key West, FL, becoming the 3rd of 6 ships of class that will eventually be homeported there. Sources: USCG, “Acquisition Update: Coast Guard Commissions Ninth Fast Response Cutter into Service”.
#9 commissioned
March 28/14: Keeping numbers up. USCGC Bainbridge Island [WPB-1343] is set for decommissioning. It was one of the modernized Island Class cutters, and the FY15 budget provides for decommissioning 8 more Island Class boats. The problem is keeping up numbers, after all of the delays and false starts chronicled in this FOCUS briefing. Chuck Hill:
“The Coast Guard plans on 58 Webber class, so presumably they would want to retain enough 110s to provide a total of 58 larger patrol craft with the 110s filling in until replaced by the new ships. It does not look like this will happen. Since the decommissioning of eight Island class as a result of the failure of the 123 conversion, there have been 41 Island class WPBs. Adding the Webber class WPCs currently commissioned that gives the Coast Guard a total of 49 large patrol craft. It appears the total will not exceed 49…. If 110s are decommissioned at the same rate Webber class are built, the number may stabilize at 49. If on the other hand the Coast Guard is unable to keep these older vessels going, the total is likely to drop.”
With just 2 FRCs funded in FY15, the smart money is on “drop.” Which is why Hill is revisiting an idea he normally hates – multi-crewing the FRCs. Sources: Chuck Hill’s CG Blog, “Decommissioning the 110s” – see also the comments section re: multi-crewing.
March 28/14: #9. The Coast Guard accepts delivery of Coast Guard Cutter Kathleen Moore [WPC 1109] in Key West, FL. Kathleen Moore is the 3rd of 6 FRCs that will be homeported in Key West, and she will be commissioned into service on May 10/14. Sources: USCG Acquisition, “Acquisition Update: Ninth Fast Response Cutter Delivered to the Coast Guard” | MarineLog, “Bollinger delivers ninth FRC”.
March 8/14: CGC. Coast Guard Cutter Charles Sexton [WPC 1108] is commissioned into service at Coast Guard Sector Key West, FL.
The cutter is named after Machinery Technician 1st Class Charles W. Sexton. On Jan 11/1991, Sexton was aboard a motor lifeboat dispatched to assist the 75-foot fishing vessel Sea King, which was taking on water off the Columbia River bar near Washington State. After boarding the ship, he helped stabilize an injured crew member and dewatered flooded compartments of the ship for 6 hours to keep it afloat. Unfortunately, the fishing vessel capsized without warning while being towed back to port, trapping and drowning Sexton and 2 of the Sea King’s crew. For his extraordinary heroism and selfless actions, Sexton was posthumously awarded the Coast Guard Medal. Sources: USCG Acquisition, “Acquisition Update: Coast Guard Commissions Eighth Fast Response Cutter into Service”.
#8 commissioned
March 12/14: Budgets. The FY15 budget isn’t good news for the Coast Guard, or the FRCs:
“The fiscal 2015 Homeland Security budget request includes $9.8 billion for the Coast Guard, an amount that would be a 6.1 percent drop in nominal terms from the current year. With inflation factored in, it would be [a] slightly higher [drop]…. The budget proposal includes funding for only two Fast Response Cutters, a number below the four a year necessary to keep per-unit costs from rising. Asked to estimate how much more expensive Fast Response Cutters might be, Papp said a planned re-compete of the cutter construction contract makes it difficult to do so.”
Sources: Fierce Homeland Security, “Papp: Budget falloff results in smaller Coast Guard”.
Feb 27/14: Namings. The Coast Guard announces the names and backgrounds of Sentinel-Class Fast Response Cutters WPC 1116 – WPC 1125, along with brief explanations of each USCG hero behind a ship name. That leaves the curious case of WPC 1115, but the USCG explains the gap to DID (links ours):
“1115 is Joseph Napier. Napier was originally scheduled to be the namesake for 1110. The Coast Guard bumped him back when they decided to name the next available FRC after [Cmdr.] Raymond Evans, who served alongside Douglas Munro at Guadalcanal [evacuating Marines] and died in 2013.”
Sources: USCG Acquisition Directorate, “Acquisition Update: Coast Guard Unveils Names of FRCs 16-25”.
Dec 10/13: #8 delivered. The US Coast Guard accepts delivery of Charles Sexton, the 8th Sentinel Class cutter. Nine more FRCs are currently in production at Bollinger Shipyards in Lockport, LA, out of 16 more ordered.
Machinery Technician First Class Charles Sexton gave his life in 1991, during a rescue operation near Washington State’s treacherous Columbia River bar. Sexton boarded the sinking fishing vessel Sea King, and worked pumps for 6 continuous hours to keep her afloat. Unfortunately, the vessel capsized without warning while being towed in. Sexton and 2 of the fishing boat’s crew members lost their lives, and he was posthumously awarded the Coast Guard Medal for extraordinary heroism. Sources: “Acquisition Update: Eighth Fast Response Cutter Delivered to the Coast Guard”.
Nov 16/13: CGC. CGC Charles David Jr. is commissioned into service at Coast Guard Sector Key West, FL, where she’s the 1st of 6 Fast Response Cutters (FRC) that be homeported there.
Steward’s Mate First Class Charles W. David Jr. was a crew member on CGC Comanche in 1943, and swam the frigid waters of the North Atlantic as part of an effort that saved 230 men from the torpedoed USAT Dorchester. Compatriots David saved included the Comanche’s executive officer, Lt. Langford Anderson, who was unable to return to CGC Comanche on his own due to hypothermia and exhaustion. David ended up dying of pneumonia 3 days later, and posthumously received both the Navy and Marine Corps Medal, and the Immortal Chaplains Prize for Humanity. Sources: USCG, “Acquisition Update: Coast Guard Commissions Seventh Fast Response Cutter into Service”.
FRC #7 commissioned
FY 2013
Approved for full rate production. 7 delivered so far, option exercised for 6 more.
Sept 25/13: +6 FRCs. The Coast Guard exercises a $250.7 million option with Bollinger Shipyards for 6 FRCs to be delivered in 2016. This brings the total under contract so far to 24 ships for $1.1 billion, against a contract ceiling of 34 ships and $1.5 billion. The contract requires that 3 to 4 cutters be ordered each year; so far, 7 cutters have been delivered, and the 7th will be commissioned in November 2013.
This 6-ship purchase was one component in $9.3 billion of US DHS discretionary funding allocated to the Coast Guard for FY 2013. The 6 boats will be homeported in Pascagoula, MS; Ketchikan, AK; and Honolulu, Hawaii. Sources: USCG, “Acquisition Update: Contract Option Exercised for Six More Fast Response Cutters” | Senator Mary Landrieu [D-LA, Chair of the Senate Appropriations Homeland Security subcommittee], “Landrieu Announces $250 Million for Louisiana Shipyard to Build Coast Guard Cutters: Funding will keep 1,200 Louisianians working”.
6 FRCs, to 24
Sept 18/13: FRP. DHS approves the Sentinel-class FRC program for full rate production after it successfully completed its Initial Operational Test and Evaluation (IOT&E). This concludes a rather beefy LRIP phase of 12 ships out of the 34 total contracted in September 2008. In its August 2012 report [PDF], the DHG IG had noted that this was a rather aggressive acquisition plan which limited the Coast Guard’s ability to control risks. Sources: USCG, “Acquisition Update: Sentinel-class Fast Response Cutter Project Achieves Acquisition Milestone”.
IOT&E / FRP
Aug 24/13: CGC. CGC Paul Clark (WPC 1106), the 6th FRC boat, is commissioned in Miami, FL. She was delivered to the Coast Guard on May 18/13.
Fireman First Class Paul Leaman Clark served as a landing boat engineer during the Allied invasion of North Africa in November 1942. After his boat came under attack by an enemy fighter, Clark assumed control of the boat, brought his wounded crewmembers to the destroyer USS Palmer, then returned the damaged boat to the beach to complete its mission. He was 1 of just 6 Coast Guardsmen awarded the Navy Cross during World War 2. Sources: USCG Acquisition Directorate, May 21/13.
FRC #6 commissioned
Aug 17/13: #7 delivered. Coast Guard Cutter Charles David Jr. is accepted by the Coast Guard in Key West, FL, and is the 1st of 6 new FRC boats that will be based there. Her commissioning is scheduled for November 2013. Sources: USCG June 29/13 release | Bollinger Aug 20/13 release.
June 13/13: Infrastructure. SitNews reports that the USCG plans to build a 405-foot floating pier and a new 3,000 square foot support building in Ketchikan, AK, in order to homeport 2 FRCs there by 2015. A 3rd FRC is slated to base in Juneau by 2020. Sitnews, “Coast Guard’s Ketchikan Project Making Progress”.
June 3/13: CGC. CGC Margaret Norvell (WPC 1105), the 5th FRC boat, is commissioned in Miami. She was delivered to the Coast Guard on March 21/13 in Key West, FL, but will be homeported in Miami.
Margaret Norvell was a lighthouse keeper near New Orleans, and is credited with a number of daring rescues during her 41 years of service. One had her rowing for 2 hours through a severe storm on Lake Pontchartrain in 1926, then heading back in with a downed naval aviator. Her lighthouse was also a key refuge for the local community during severe storms. Sources: USCG Acquisition Directorate, March 21/13 and June 3/13 | Coast Guard Compass, “Coast Guard Heroes: Margaret Norvell”.
FRC #5 commissioned

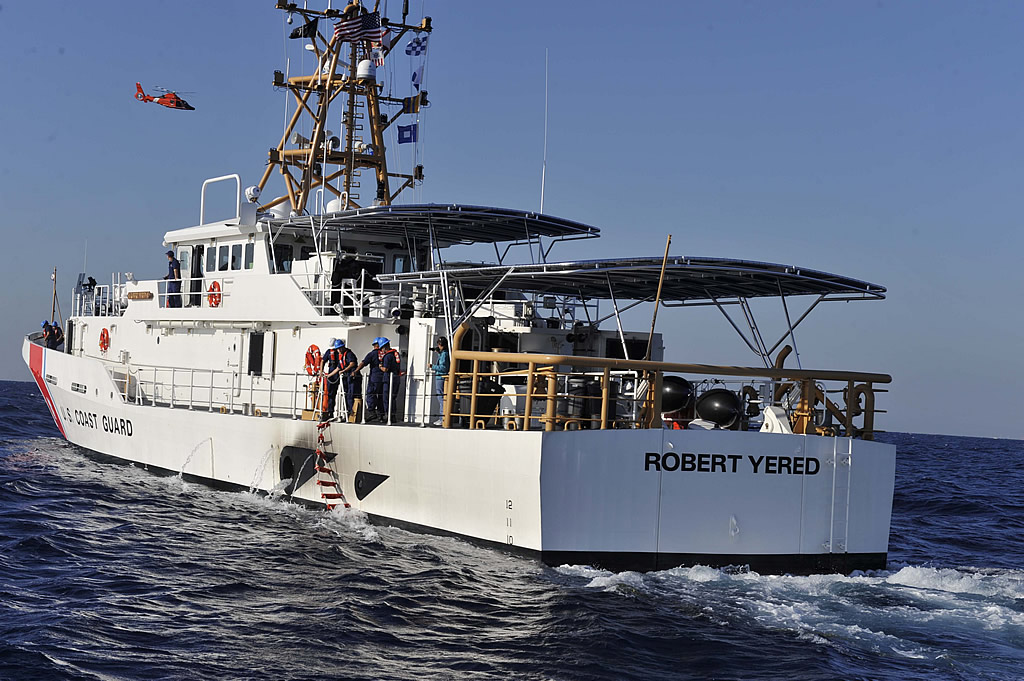

Feb 15/13: CGC. CGC Robert Yered (WPC 1104), the 4th FRC boat, is commissioned. The ship was delivered on Nov 17/12, and will be homeported in Miami.
The boat is named after Coast Guard Engineman and ammunition specialist First Class Robert J. Yered, who basically saved Saigon Harbor during the Vietnam War. A barge carrying several hundred tons of mortars had been hit by enemy rocket fire, and there were 15 Kilotons of explosives at risk, including 2 more ammunition ships nearby. Yered climbed onto the burning barge, under enemy fire, to extinguish the flames. He is one of only 12 Coast Guardsmen to ever receive the Silver Star medal for heroism. Unfortunately, he died of a heart attack at age 69 before he could see this, but his father and family were there. Sources: USCG Acquisition Newsroom, Nov 20/13 release | Coast Guard Compass, “Coast Guard Heroes: Robert J. Yered” | Coast Guard Compass, “He lived and breathed the Coast Guard”
FRC #4 commissioned
FY 2011 – 2012
6 more ordered, 3 commissioned.
Nov 3/12: CGC. CGC William Flores (WPC 1103), the 3rd FRC boat, is commissioned into service in Tampa, FL.
She will serve from Miami, but Tampa was the site of the Coast Guard’s worst peacetime loss of life in 1980, when the oil tanker Capricorn hit CGC Blackthorn and ripped the buoy tender open with its anchor. Seaman apprentice William Ray Flores was 1 of 23 crew members who died in that accident, as he chose to stay aboard to help shipmates rather than abandon ship. He received the Coast Guard Medal as a posthumous honor, and now has a ship named after him. Sources: Coast Guard Compass, “Fulfilling a promise: The commissioning of Coast Guard Cutter William Flores.”
FRC #3 commissioned
Sept 21/12: The Coast Guard exercises a $250 million contract option with Bollinger Shipyards of Lockport, LA for 6 more Fast Response Cutters. All 6 Sentinel Class boats are scheduled to be delivered in 2015, and homeported in San Juan, Puerto Rico.
This option brings the total number of FRCs ordered to 18 of a possible 34 boats, and the total value of the contract so far to nearly $880 million. FRC #4, the William Flores, will be commissioned Nov 3/12, and the Robert Yered will become the 4th cutter delivered sometime in November 2012. Sources: USCG.
6 FRCs, to 18
Aug 15/12: #3 delivered. Bollinger delivers William Flores, in Key West, FL. Flores will be commissioned into service in Tampa, FL on Nov 3/12, and homeported alongside the first 2 FRCs in Miami. Indeed, the first 6 FRCs are scheduled to be stationed in Miami to support operations in the 7th Coast Guard District, an area ranging from the South Carolina coast to the Caribbean. Sources: USCG | Bollinger Shipyards.
Aug 3/12: CGC. CGC Cutter Richard Etheridge (WPC 1102), the 2nd FRC boat, arrives at Port Everglades, FL and is commissioned into service. Her motto, “In Behalf of humanity,” stems from a letter written by the ship’s namesake. USCG Blog | USCG Flickr Stream.
FRC #2 commissioned
April 24/12: FRC, Ready for Sea. CGC Bernard C. Webber (WPC 1101) is certified “Ready for Sea” – the minimum capabilities to get underway for extended periods of time, safely manage major emergencies at sea, and effectively conduct follow-on training, testing and evaluation. The final stage is a certification of Ready for Operations. USCG.
April 14/12: CGC. The 1st FRC boat becomes CGC Bernard C. Webber (WPC 1101), at a commissioning ceremony in Miami, FL. USCG.
FRC #1 commissioned
Feb 24/12: Phase II RDLP. The Coast Guard exercises a $27.2 million contract option with Bollinger Shipyards of Lockport, LA for the FRC’s Reprocurement and Data License Package (RDLP), bringing the total current contract value to $628 million
The RDLP will provide the Coast Guard with the required design data, drawings, materials list, and technical and testing information necessary to allow a competition for the follow-on Phase II FRC production contract. The RDLP will reflect the FRC’s design maturity as of Feb 23/12, and its production phase contract is scheduled to be awarded in fiscal year 2015. USCG.
Phase II RDLP
Feb 10/12: CGC Bernard C. Webber, the 1st FRC, arrives at her homeport of Port Everglades, near Miami, FL. When the contract was signed, delivery was slated for fall 2010. USCG Blog.
Sept 22/11: The Coast Guard announces a $179.7 million contract option to Bollinger Shipyards of Lockport, LA, for 4 more Fast Response Cutters, bringing the total number of FRCs under contract with Bollinger to 12 of a possible 34, with a contract value so far of $597 million. USCG | Bollinger Shipyards.
4 FRCs, to 12
Sept 8/11: RFI. FBO.gov Solicitation Number HSCG23-11-I-FRCXXX: “Request for Information (RFI) to support the Department of Homeland Security (DHS) United States Coast Guard (USCG), Commandant (CG-9125), Fast Response Cutter (FRC) Reprocurement.”
Phase II will complete the FRC acquisition, bringing it up to 58 hulls. If the Coast Guard exercises all options on the initial FRC-B contract with Bollinger, Phase II will be 24 ships. That FRC-B contract makes all ships beyond the 1st options, however, which means the USCG could decline to buy additional cutters from Bollinger, or buy fewer than 34, and award “Phase II” construction options to a different vendor until 58 have been bought.
As the unofficial CGBlog points out, The Coast Guard’s last contract also covered the design rights, which means a different shipyard could conceivably produce the Sentinel Class design. They would begin from a disadvantage when compared to what Bollinger has learned by building that design to date, but a switch is not impossible. The RFI also implies that different designs might be considered, however, which could open the competition to options like Westport’s GRC43. From FBO.gov:
“At this time, the U.S. Coast Guard is interested in meeting only with U.S. shipyards that have the organic capability to design and construct cutters of the FRC’s complexity as described in the U.S. Coast Guard’s 2007 Request for Proposal (PDF).”
FRC Phase II RFI
Aug 18/11: #2 Launch. The Richard Etheridge is launched at Bollinger Shipyards in Lockport, LA. This 2nd Sentinel Class cutter will undergo a series of tests and evaluations prior to its planned delivery to the USCG early in 2012. Cutter #3, the William Flores, is tentatively scheduled to be launched on Nov 10/11.
In 1880, Richard Etheridge became the first African-American to command a life-saving station. In 1886, he and his crew earned the Coast Guard’s Gold Lifesaving Medal, for their daring rescue of the schooner E.S. Newman. USCG.

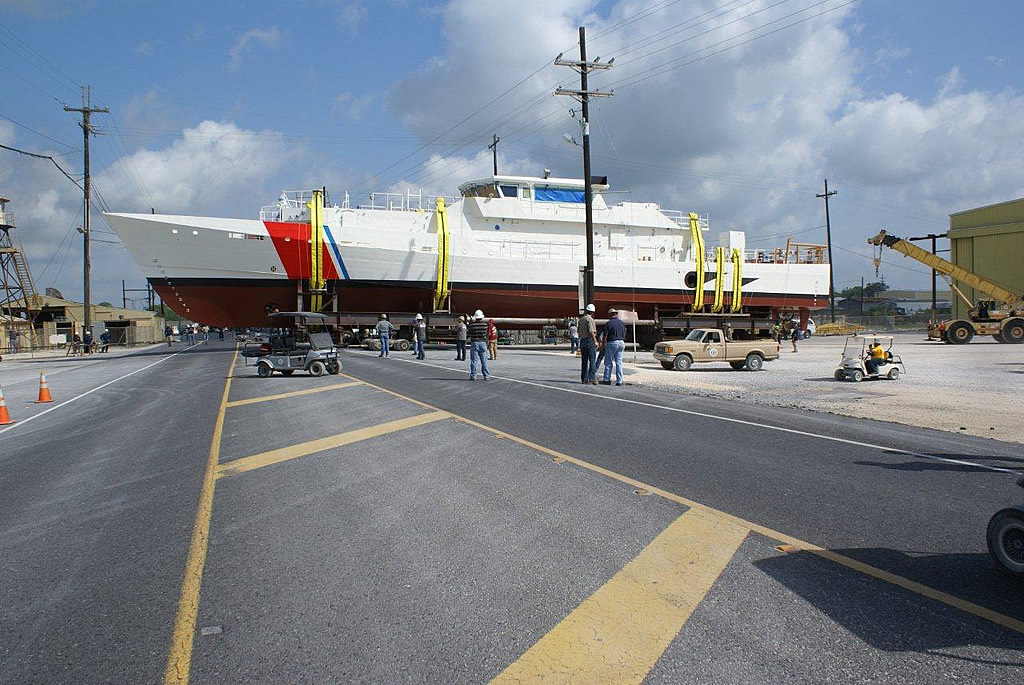

April 21/11: #1 Launch. The 1st FRC cutter, Bernard C. Webber, enters the water after a 3-day journey from the fabrication shop, which included a tow across Highway 308. It now sits pier-side in Lockport, LA. USCG Compass, incl. photos | Bollinger.
April 14/11: Leadership. Bollinger Shipyards, Inc. announces the appointment of Charles “Skip” Bowen as Program Manager for the FRC Sentinel Class Patrol Boat program. Mr. Bowen joins Bollinger after 32 years with the United States Coast Guard, culminating with the rank of Master Chief Petty Officer of the Coast Guard from 2006 – 2010.
Oct 27/10: Naming. The US Coast Guard announces its decision to name all FRC Sentinel Class cutters after enlisted Coast Guard heroes, who distinguished themselves in USCG or military service. The first 14 boats have now been named. USCG Compass.
FY 2009 – 2010
GAO protest denied. Low Rate Initial Production.
Sept 23/10: State of the Fleet. US Coast Guard’s official Compass blog:
“During Haiti relief operations this past January, 10 of the 12 assigned Coast Guard cutters, or 83 percent, suffered significant mechanical problems that impeded their ability to respond to the catastrophic aftermath of the earthquake. Three had to suspend relief activities and leave the area to perform extensive repairs, including drydocking one ship.”
Sept 14/10: The US Coast Guard exercises a $166.1 million contract option with Bollinger Shipyards of Lockport, LA for 4 more Sentinel Class Fast Response Cutters (FRCs), bringing the total contract value so far to $410.7 million for 8 ships. The entire FRC contract contains options for up to 34 cutters, and is worth up to $1.5 billion (vid. Sept 26/08 entry).
The lead Fast Response Cutter, Bernard C. Webber, is approximately 70% complete, and is expected to be delivered to the Coast Guard in the spring 2011. The other 3 FRCs ordered to date are currently under construction: #2 is about 40% complete, #3 is 15% complete, and #4 is just 1% complete, at the moment. USCG | Bollinger Shipyards.
4 FRCs, to 8
Dec 15/09: The US Coast Guard awards Bollinger Shipyards of Lockport, LA a $141 million contract option to begin production of 3 more Fast Response Cutters.
Having successfully cleared its Critical Design Review last month and the Department of Homeland Security’s Acquisition Review Board earlier in December, the Sentinel project is now approved to begin low-rate initial production (LRIP). US Coast Guard | Bollinger Shipyards.
LRIP; 3 FRCs to 4
April 9/09: #1 Keel Laid. A keel laying ceremony for the first FRC takes place at Bollinger Shipyards in Lockport, LA. To honor past Guardians who stood the watch, each Sentinel-class FRC will be named for one of the Coast Guard’s many enlisted heroes.
The Bernard C. Webber will be home ported in Miami, FL, and is expected to be delivered in spring 2011. Webbers daughter, Ms. Pattie Hamilton, is the ship’s sponsor, and his granddaughters, Leah and Hilary, are the maids of honor. US Coast Guard| USCG iCommandant blog | Gannett’s Navy Times.
March 22/09: Naming. US Coast Guard officials announce that the first Sentinel-class cutter will change its name from Sentinel to “Bernard C. Webber,” in honor of a legendary Coast Guard member. Master Chief Petty Officer of the Coast Guard Charles “Skip” Bowen:
“We were on the plane ride back from Bernie Webber’s funeral and we got to talking about what a great opportunity we have to tie these ships to our heritage and legacy… The commandant gave me leave to go and rattle the bureaucracy to change what we’d approved for the names of these cutters, to name them after enlisted Coast Guard heroes.”
This 1st Sentinel Class FRC will be named the Bernard C. Webber, after a coxswain from Station Chatham, MA. On February 18, 1952, Petty Officer Webber led his 3-man crew through a fierce Cape Cod winter storm’s 60-foot waves, in order to save the lives of 32 crewmen from the SS Pendleton, a 504-foot freighter that had been split by onboard explosions. His craft? The 32-foot Motor Life Boat CG36500. Petty Officer Webber and his crew, Andrew Fitzgerald, Richard Livesey and Irving Maske, were each awarded the Coast Guard’s Gold Lifesaving Medal for their heroic actions in the rescue.
In a long-delayed echo, the USCG recently took the time to award Peter Kennedy of the Orleans Historical Society its Meritorious Public Service Award, for restoring Webber’s CG36500 and turning it into a floating museum. CG36500 was added to the US National Register of Historic Places in 2005. US Coast Guard | USCG ALCOAST transmission | USCG iCommandant blog | 8th Coast Guard District’s Heartland Guardian blog.
Jan 28/09: The U.S. Government Accountability Office denies Marinette Marine Corporation’s protest of Bollinger Shipyards’ contract win, which authorized the shipyard to design and build the Sentinel Class Fast Response Cutters based on a Damen design.
The FRC-B program, which had been frozen during the protest process, may now move forward. GAO decision | Washington Technology.
Oct 8/08: Bollinger shipyards files a formal protest with the Congress’ Government Accountability Office over the contract award to Marinette Marine. Meanwhile, the 2 firms continue to cooperate as joint members of the team building Lockheed Martin’s Littoral Combat Ship design. Defense News.
GAO gives FRC OK
FY 2007 – 2008
FRC-A shelved. Initial Sentinel-class contract.
Sept 26/08: The US Coast Guard announces that Bollinger Shipyards, Inc. will receive an initial $88 million firm-fixed-price contract with economic price adjustment contract to begin building the 1st Sentinel class (FRC-B) Cutter. With the global price of steel skyrocketing, economic price adjustment contracts are important addenda to shipbuilding contracts these days. The approximate maximum value of this contract, if all options are exercised and all 34 patrol boats are ordered, is about $1.5 billion over 6-8 years.
The ships will be built at Bollinger’s shipyard in Lockport, LA, and the first ship is scheduled for delivery to Miami’s Coast Guard District 7, in the fall of 2010. It will complete a comprehensive operational test and evaluation period, and then enter operational service in the Caribbean. USCG release [PDF] | USCG Backgrounder | USCG Sentinel Class page | MarineLog.
FRC-B Phase I contract, incl. 1st FRC
July 11/08: Gannett’s Navy Times reports that the early July 2008 target for an FRC-B purchase decision is going to slip to September or October.
The USCG has not disclosed how many companies responded to its Request for Proposals, but Rear Adm. Gary Blore says in a July 11 memo that a new round of discussions “will provide all offerors in the competitive range an opportunity to improve their proposals and address any deficiencies and/or weaknesses… To accommodate these additional discussions… the anticipated contract award date is now September or early October of this year.”
March 11/08: GAO Report. The US Government Accountability Office releases report# GAO-08-270R: “Status of Selected Aspects of the Coast Guard’s Deepwater Program” [Report page | Plain text | PDF, 20 pages]. Key passages related to the FRC program include:
“Since the FRC-A acquisition effort began, the Coast Guard obligated approximately $35 million to ICGS for the design of this asset, but a viable design has not been produced. Coast Guard officials told us that at this time design efforts remain suspended; they do not expect to incur any additional costs related to the FRC-A. The original estimate for the fleet of 58 FRC-As was approximately $3.2 billion. Due to high risk and uncertain cost savings, Coast Guard officials recommended to the Commandant that the Coast Guard not pursue acquisition of an FRC-A design that includes unproven composite hull technology. The officials told us this recommendation was largely based on a third-party analysis that found the composite technology unlikely to meet the desired 35-year service life under the Coast Guard’s operational conditions.”
Coast Guard officials do not plan to update cost estimates for the FRC-B until after the contract is awarded. The Coast Guard is currently evaluating proposals and expects to award the FRC-B contract in the third quarter of fiscal year 2008, with the lead cutter to be delivered in 2010. Coast Guard officials stated that their goal is still to acquire 12 FRC-Bs by 2012. The contract will include a 2-year base period for the design and production of the lead cutter and six 1-year option periods. The first option period includes 3 low-rate initial production cutters, and the subsequent five option periods include an option of 4 or 6 cutters each. The Coast Guard intends to award a fixed price contract for design and construction of the FRC-B, with the potential to acquire a total of 34 cutters… Coast Guard lowered the minimum requirement for sprint speed from 30 knots for the FRC-A to 28 for the FRC-B… [small boat] stern ramp launch… capability is not required on the FRC-B… would be safer and require fewer crew to operate… eliminating these design requirements would ensure more competition on the open market and meet their urgent need for patrol boats.”
March 11/08: VT Halter team. Raytheon, VT Halter Marine Inc., and URS subsidiary EG&G Technical Services announce that they are teaming on the Fast Response Cutter-B (FRC-B) program. The design is not specified, but it will almost certainly be a VT Halter hull. Raytheon release.

March 3/08: After receiving the service’s formal “Deepwater alternatives analysis” in February 2008, USCG Chief Acquisition Officer Rear Adm. Gary Blore forwards recommendations to Coast Guard senior leadership in a formal decision memorandum. Commandant Adm. Thad Allen is expected to approve Blore’s decision in the near future – which includes a decision not to proceed with development of the FRC-A composite-hull cutter. Inside the Navy’s March 10/08 report [PDF] explained:
“Despite a recommendation to pursue a composite hull for the Fast Response Cutter (FRC), the Coast Guard has decided to pursue an existing ship design yet to be selected, Blore said. The service felt the study “undervalued the cons” to using a composite material for the ship’s hull, the admiral added… They [ABSG] acknowledge that the technology readiness and manufacturing readiness of composite patrol boats is less than conventional construction by a good margin,” [USCG acquisitions director] Blore said. “We kind of think that” a showstopper,” he added. “We’re very much a state-of-the-market organization – we don’t have developmental funds…”.”
FRC-A shelved
June 27/07: Legal wranging. Lockheed Martin and Northrop Grumman send a return letter, contesting the legality of the USCG’s revocation of acceptance – and hence the ICGS Deepwater consortium’s liability for refunds. ICGC had also sent a letter on May 23/07, which was followed by the Coast Giuard letter on June 5/07. The legal moves are on. POGO report | PDF of letter.
May 17/07: RoA Letter. The US Coast Guard takes the first legal steps to recoup up to $100 million from the contractors who oversaw the failed Island Class cutter modernization, via a revocation of acceptance letter. WIRED’s Danger Room later relays a Defense Daily report that:
“Richard Skinner, the IG, said his office is having difficulty getting accesses to people and records belonging to Integrated Coast Guard Systems (ICGS) during its investigation of the cutter program. For instance, Skinner said that ICGS wants a lawyer to be present whenever one of its employees meets with the IG, something that would jeopardize the confidentiality of the encounter. This is something Skinner said he had never seen before as a government inspector.”
Whatever the merits or demerits of the contractor’s conduct, this seems like the only possible response after leading Congressmen have openly called for fraud charges to be laid against the firm and/or its employees. Though it’s hard for many politicians to grasp, there is sometimes real value in keeping one’s cards close and one’s words careful in these situations. Seattle Times article | WIRED Danger Room article.
April 17/07: Commandant Admiral Thad Allen announces that the converted patrol boats that had experienced hull cracking will be permanently decommissioned – and that the Coast Guard will take over the lead integrator role from ICGS Deepwater.
Island Class, ICGS both out
Appendices: A Chronicle of Failure – Island Class Upgrades, and FRC-A
Appendix A: Down on the Islands – The Suspended Modernization

The Island Class extension program was just a small part of the Deepwater program constellation. While the proposal was still under development, Bollinger Shipyards, Inc. in Lockport, LA formed a consortium with Halter Marine, Inc of Gulfport, MS; creating Halter-Bollinger JV (HBJV). This firm was intended as a joint venture sub-contractor to Northrop Grumman Ship Systems for the Deepwater program, and immediately pursued the contract to modify and lengthen the 49 Island Class vessels specified in the interim plan.
On April 20, 2005, Adm. Collins told Congress that:
The 110-foot Patrol Boat fleet has experienced 23 hull breaches (literally an opening in the hull from corrosion) requiring emergency dry docks. The resultant loss in operational days poses unacceptable risks to our personnel. By the end of 2005, the Coast Guard will have taken delivery of eight reconfigured 123-foot patrol boats, which are upgraded 110-foot patrol boats designed to sustain this cutter class until replacement with the Integrated Deepwater System’s Fast Response Cutter.
Changes in the reconfigured craft included an extra 13 feet of length (to 123 feet), an 11-ton extension to their sterns, and a larger and slightly heavier upper works amidships. The modifications were intended to accommodate dual-gender quarters, a more robust communications suite, and a boat ramp on the stern.
The $367.5 million dollar conversion program had been announced during February 2003 by Fred P. Moosally, a Lockheed Martin luminary and former vice-chairman of ICGS. He is currently president of Lockheed Martin’s Naval Electronics & Surveillance Systems (NESS) business segment. When the first modernized cutter was delivered on March 8, 2004, Moosally opined that the ICGS’ conversion of the aging vessels would produce “a modernized fleet and an interconnected Coast Guard that will be the envy of the world.”
They did not.
During sea trials with the lead ship in the summer of 2004, the USCGC Matagorda cracked amidships at [structural] Frame 22 while running at approximately 24 knots near Key West in Sea State 5 conditions (8-12-foot seas). By March 2005, the converted cutters Nunivak and Padre also began experiencing problems with hull buckling. That same month, similar hull deformations were discovered in 3 other modified boats: the Metompkin, Vashon, and Monhegan. As a result of the deteriorating hull conditions, the Coast Guard imposed operational restrictions on the boats in April 2005.
Halter-Bollinger JV could not produce a viable plan to fix them. The alternations had changed the vessels’ center of gravity, and the vibration patterns throughout their hulls. This created new levels of stress in areas of the ship that had not been built to take them, in a set of hulls that were already quite old and fatigued when the conversions were started.
On November 30, 2006, the official word was finally given. All 8 ships were officially placed in limbo and taken out of service, more than 2 years after the first ship began buckling in heavy seas. The 8 stricken ships are all that remains of ICGS’s plan to “add 15 years of life” to all 49 Island Class patrol craft.
Scathing December articles by the New York Times and Washington Post would follow. An enlisted sailor who had served on one of the cutters was more succinct when talking to reporter Nat Helms:
“It’s hosed.”
Appendix B: Not-So Fast Response – The Catch With Composite Cutters
Hence the acceleration of the Deepwater Fast Response Cutters – but these Island Class replacements haven’t fared much better. On June 22/05, Adm. Collins told the US Senate that:
“Last month, I directed that Deepwater’s conversion of 110-ft. patrol boats be terminated at eight hulls for several reasons… Several steps have been taken to mitigate the near-term operational impact of this termination. For the long term, the Coast Guard has advanced the design and construction of the new Fast Response Cutter by a full decade. The revised Deepwater implementation plan builds improved post-9/11 capabilities into this cutter’s design and delivers it far sooner than originally planned.”
On Sept.16/05, the U.S. Coast Guard and ICGS successfully completed the preliminary design review for the 58 FRC vessels, giving the project their official go-ahead. By April 28, 2006, the GAO gave Deepwater a review that lauded improvements to the program. The Coast Guard extended ICGS’ contract, and went into its June 2006 presentations on Capitol Hill buoyed with confidence fueled by improving assessments and the service’s excellent performance during the Gulf Coast hurricane disasters of 2005.
Right on the heels of those testimonies, however, the service was rocked by the release of a June 23, 2006 Government Accountability Office (GAO) report detailing the Coast Guard’s attempt to oversee the integration of composite materials into the current FRC design, involves building the FRC’s hull, decks, and bulkheads out of composites rather than steel or aluminum. As GAO noted in its June 23, 2006 report:
“It calls for the use of two types of composite materials: (1) a solid laminate form consisting of layers of glass-reinforced plastic and (2) a “sandwich” form consisting of two thinner layers of glass-reinforced plastic surrounding a core of either balsa wood or synthetic foam. The solid laminate form is to be used for the hull, which is to be constructed from a mold in a single process. The sandwich form, which weighs less than the solid form, is to be used on decks and bulkheads…
In February 2006, however, the Coast Guard suspended FRC design work after an independent design review by third-party consultants demonstrated, among other things, that the FRC would be far heavier and less efficient than a typical patrol boat of similar length, in part, because it would need four engines to meet Coast Guard speed requirements…”
Composite materials have been used to build a number of foreign warships, from Sweden’s famous 74 m/ 250 foot Visby Class fast stealth corvettes, to Norway’s smaller and faster Skjold (“Shield”) Class 47.5 m/ 158 foot catamaran-hovercraft design. Composites provide substantial radar stealth benefits, and also offer the prospect of lower maintenance due to fewer corrosion problems in a salt-water environment. Both benefits continue to grow in importance as drug lords employ increasingly sophisticated technologies, and military maintenance budgets continue to grow.
On the other hand, composites come with trade-offs like less stiffness, and questions of long-term durability when subjected to the pounding of high waves on a regular basis. Learning how to use the new materials effectively isn’t something that happens immediately, and there has been criticism that the Coast Guard was over-optimistic about this prospect. Worse, they lacked a clear “Plan B.” Overall, the June 2006 GAO report was extremely critical of the project and its execution. Their bottom line? “The Coast Guard has spent approximately $26.7 million for design and test efforts on the FRC, although it has yet to produce a viable design.”
In response to these difficulties, the US Coast Guard initially took a “dual-path” approach. The first part of that path involved dividing the 58-ship Fast Response Cutter effort into two classes. 12 would be FRC-Bs bought as a near-term stop gap measure, based on an existing patrol boat design with minor modifications, and licensed for construction in America.
In pursuit of that approach, the Coast Guard looked at 27 designs, from 19 manufacturers around the world. An Oct 24/06 Defense News article quoted Rear Adm. Gary Blore, head of the Deepwater program:
“Blore noted that 19 international manufacturers with 27 different designs responded to a request for information put out in February to seek patrol boats that might meet Coast Guard requirements. None of the initial submissions met those requirements, Blore said, so the service modified some of its specifications. As a result, “five or six” of the designs show promise, Blore said.
The Coast Guard is looking for a vessel from 140 to 160 feet in length, Blore said – shorter than a number of the foreign designs.”

For the 46 subsequent FRC-As, the future initially involved more wait-and-see. The GAO’s March 8, 2007 report explains in more detail:
“…According to Coast Guard officials, unlike the original plans, [FRC-B] is not expected to meet all performance requirements originally specified, but is intended as a way to field an FRC more quickly than would otherwise occur and that can, therefore, serve as an interim replacement for the deteriorating fleet of 110-foot patrol boats.
The second component of the dual-path approach would be to completely redesign an FRC to address the problems in the original FRC design plans. However, due to continuing questions about the feasibility of its planned composite hull, the Coast Guard has delayed a decision about its development or acquisition until it receives results from two studies. First, the Coast Guard is conducting a business case analysis comparing the use of composite versus steel hulls… Second, the Coast Guard told us that DHS’s Science and Technology Directorate will be conducting tests on composite hull technology, and that it will wait to see the results of these tests before making a decision on the redesigned FRC. Until recently, the Coast Guard anticipated delivery of the redesigned FRC in 2010. However, the decision to not request funding for this redesigned FRC in fiscal year 2008, and to await the results of both studies before moving forward, will likely further delay delivery of the redesigned FRC…
…Concurrent with the first two strategies, the Coast Guard’s third strategy is to have a third party reassess the analyses used in the decision to use composite materials for the FRC to determine if the use of composite materials will, in fact, reduce total ownership costs. The result of the Coast Guard pursuing these strategies is that the Coast Guard would end up with two classes of FRCs. The first class of FRCs to be built would be based on an adapted design from a patrol boat already on the market, to expedite delivery, and a follow-on class that would be based on revisions made to address the problems identified in the original FRC design plans.”
If they could. In the end, they could not.
Enter Plan B: an FRC-B competition that would abandon development of a new design in favor of currently fielded designs around the world. It would eventually become the sole procurement strategy.
March 2007: What Next?

Congressional Research Service report #RL33753, last updated on December 22, 2006, noted that “some observers have expressed concern the estimated total acquisition cost of the Deepwater program has grown over time from $17 billion to $24 billion.” While this is true, much of that cost growth stems from expansion of the Coast Guard’s mission after 9/11. A larger mission requires more assets and capabilities, and so the underlying Deepwater plan was revised. It would be far more accurate to say that the Deepwater I plan had an estimated cost of $17 billion, while the post/9/11 “Deepwater II” plan grew to over $24 billion.
Overall cost is not yet a major issue for Deepwater. Performance to date, and confidence in the Coast Guard’s acquisition system, are. This confidence is so shaken that The May 22, 2006 House Appropriations Committee report on H.R. 5441 (H.Rept. 109-476) denied the $41.6 million request for the production of the Fast Response Cutter (FRC): “Until ongoing problems are resolved, the Committee cannot continue to support a program that has so much risk of failure that it may be terminated or substantially revised…” The June 29, 2006 Senate Appropriations Committee report (S.Rept. 109-273) took a related approach: “To address this gap, the recommendation rescinds $79,200,000 from balances in the Fast Response Cutter program and reappropriates these funds for the purchase of off-the-shelf replacement patrol boats to address the patrol boat gap as soon as possible.”
This stance survived reconciliation into December 2006. The USCG can re-submit the FRC request in future, but changes will be required in order to secure political confidence.
At a lower level, the sunk cost dollars for Island Class conversions and FRC designs certainly contribute to cost issues with Deepwater II. Yet the key questions concerning the Island Class replacement effort are not really monetary. The first order of business is deciding how to approach the problem of having a serviceable patrol fleet, now that existing approaches have failed or stalled. As noted above, the full answer has not yet become clear – and the FY 2008 budget does not include an FRC-A funding request.
Meanwhile, broader changes are underway in order to restore confidence in the Deepwater program. The reassignment of the FRC-B procurement from ICGS is the first major change to flow out of that reality. Others are in the works. From Adm. Thad Allen’s testimony to Congress on February 8, 2007 [PDF]:
“I’ve taken steps to ensure that the Coast Guard maintains vigilant oversight of contractors and project management:
- I’ve reaffirmed in writing the role of the Coast Guard’s chief engineer as the technical authority for all acquisition projects.
- I’ve directed independent, third-party design reviews as new assets are developed or major modifications to assets are contemplated.
- I am cultivating a more robust relationship with the Naval Sea and Air Systems Commands [DID: NAVSEA & NAVAIR] to leverage outside technical expertise.
“…In my opinion, the challenges we are dealing with in the Deepwater Program are not the result of a flawed contract or acquisition design. Rather, they are the result of the Coast Guard not being adequately positioned early on to manage an integrated acquisition of this size. We’re taking decisive action now to fix that. We cannot manage a simultaneous and complex acquisition of this size with a system integrator without an integrated Coast Guard…”
In a bureaucracy, people are policy. So…
“In the coming months, you will see significant changes inside the Coast Guard’s acquisition directorate to bring all acquisition efforts – traditional as well as system-of-systems – under one organization. Rear Admiral Blore will become the Coast Guard’s Chief Acquisition Officer, with responsibility over all procurement projects, including Deepwater and the continued management of ongoing projects such a Rescue 21, our Response Boat-Medium and Nationwide Automatic Identification System. The Program Executive Officer for Deepwater will work within the new organization. I have asked Rear Admiral Ron Rabago, a naval engineer, former Commanding Officer of the Coast Guard Yard, and a technical expert on naval engineering issues to take Deepwater’s “helm”…”
“Under the Blueprint, reinvigorating our acquisition training and certification process to ensure that acquisition staff, program managers and contracting officers have the requisite skills and education needed to manage this complex program.”…
Steps are also being taken to assure better independent scrutiny of contractors and projects – and in some cases, to remove them from the integrated systems approach:
“…we’ve redefined our award term and award fee criteria, making them more objective in order to improve contractor performance. As resources allow, the Coast Guard will assume greater responsibility as the system integrator, a role we now feel better positioned to take on. We are also taking steps to limit the use of self-certification by ICGS by requiring that new cutters be classified by the American Bureau of Shipping (ABS)…”
The Coast Guard’s March 14/07 statement RE: FRC-B’s removal from Integrated Coast Guard Systems’ purview was careful to note that “…this decision pertains only to the acquisition of patrol boats and does not impact ongoing negotiations with ICGS for other work to be done in the second performance period of the Deepwater contract, beginning June 2007.” Nevertheless, the Blueprint for Acquisition Reform that Adm. Allen discussed with Congress on February 8, 2007 definitely lays the groundwork for further shifts if performance does not improve.
In many ways, this is a welcome move. In the wake of DeKort’s revelations and the December 2006 exposes, it’s impossible to maintain that the contractors at ICGS have discharged their responsibilities with the Coast Guard’s interests uppermost in mind. Without meaningful penalties and the realization that more may come, organizations tend not to make the required policy and personnel adjustments, and poor behaviors are perpetuated.
Deepwater was conceived as an integrated program, however, a status that requires a sufficient suite of linked programs to manage. Further failures and reassignments could well call this status into question, especially given the fact that external reviewers like the GAO have been skeptical of the model’s suitability for some time.
The one essential truth behind all of these maneuvers is the US Coast Guard’s serious and growing need to replace worn equipment. All else is ultimately variable; the Coast Guard must and will do whatever it takes to secure the confidence and funding it needs, in order to address that underlying truth.
Nat Helms contributed reporting to these appendices.
Additional Readings
Background
- USCG – Integrated Deepwater System TEMP [PDF]
- GlobalSecurity.org – Deepwater
- USCG – 110-foot Patrol Boat (WPB) – Island Class
- Bollinger Shipyards – USCG 110′ “Island Class”
- USCG, Integrated Deepwater Systems – 123′ Maritime Patrol Boat – WPB (Legacy 110′ Modification)
- USCG (March 14/07) – Fact Sheet – Fast Response Cutter-B. Accompanies the announcement that FRC-B was being reassigned from Deepwater to the Coast Guard.
- Naval Technology – Skjold Class Missile Fast Patrol Boats, Norway
- Naval Technology – Visby Class Corvettes, Sweden
- Military.com (June 23/05) – Coast Guard Scramble Over Deepwater Snag. By Nat Helms. Describes early issues with Deepwater programs, from the Island class to the new CN-235 aircraft to wing box cracking in the service’s existing C-130s. Includes more detailed technical descriptions of the problems with the Island Class cutters.
- DID (Jan 3/06) – Cobham Catches A$ 1B CoastWatch Contract. Australia has a very different and interesting outsourcing approach to its Coast Guard function, which is also its border patrol. This article deals with the renewal of their multi-year CoastWatch contract.
Official Reports
- Homeland Security Inspector General (August 2012) – U.S. Coast Guard’s Acquisition of the
- IBM Center for the Business of Government (December 2008) – The Challenge of Contracting for Large Complex Projects: A Case Study of the Coast Guard’s Deepwater Program. The Island Class cutter program is cited as a notable failure.
- US GAO (#GAO-08-270R March 11/08) – Status of Selected Aspects of the Coast Guard’s Deepwater Program
- US GAO (#GAO-07-575T, March 8/07) – Coast Guard: Status of Efforts to Improve Deepwater Program Management and Address Operational Challenges
- US GAO (#GAO-07-446T, Feb 15/07) – Coast Guard: Preliminary Observations on Deepwater Program Assets and Management Challenges
- US GAO (#GAO-07-460T, Feb 14/07) – Coast Guard: Coast Guard Efforts to Improve Management and Address Operational Challenges in the Deepwater Program
- US GAO (#GAO-07-453T, Feb 8/07) – Homeland Security: Observations on the Department of Homeland Security’s Acquisition Organization and on the Coast Guard’s Deepwater Program
- Committee On Oversight And Government Affairs, US House Of Representatives (Feb 8/07) – Statement Of Admiral Thad W. Allen, Commandant, On The Procurement Practices Of The Department Of Homeland Security: Integrated Deepwater Systems [PDF]. This is a key document regarding the future of Deepwater, and of USCG acquisitions. An almost identical submission was made to the United States Senate Committee on Commerce, Science & Transportation on February 14, 2007.
- USCG (Jan 30/07) – Statement Of Adm. Thad Allen On The Integrated Deepwater System [MS Word], Before The House Transportation & Infrastructure Subcommittee On Coast Guard & Maritime Transportation
- Congressional Research Service (#RL33753) – Coast Guard Deepwater Program: Background, Oversight Issues, and Options for Congress
- Congressional Research Service (updated Sept 6/06) – Coast Guard Deepwater Program: Background and Issues for Congress. Google HTML from PDF conversion | Original PDF.
- US GAO (#GAO-06-764, June 23/06) – Coast Guard: Status of Deepwater Fast Response Cutter Design Efforts
- DID (May 25/06) – US Coast Guard Gets GAO Praise, Extends ICGS Deepwater Contract to 2011
- US GAO (#GAO-06-546, April 28/06) – Coast Guard: Changes to Deepwater Plan Appear Sound, and Program Management Has Improved, but Continued Monitoring Is Warranted
- US GAO (#GAO-05-757, July 22/05) – Coast Guard: Progress Being Made on Addressing Deepwater Legacy Asset Condition Issues and Program Management, but Acquisition Challenges Remain
- US GAO (#GAO-05-651T, June 21/05) – Coast Guard: Preliminary Observations on the Condition of Deepwater Legacy Assets and Acquisition Management Challenges
Official Statements
- USCG (March 14/07) – Coast Guard Reassigns Deepwater Replacement Patrol Boat Acquisition Project
- USCG (Nov 30/06) – Coast Guard Suspends Converted Patrol Boat Operations
- ICGS Deepwater (Nov 14/06) – Deepwater Team Issues Broad Industry Announcement Calling For Fast Response Cutter Proposals
- USCG (Sept 7/06) – Statement Of Adm. Thad W. Allen Before The Senate Committee On Appropriations Subcommittee On Homeland Security
- USCG (Sept 1/06) – Fact Sheet: The Coast Guard Since Sept. 11, 2001. Illustrates the scope of other changes underway.
- USCG (June 14/06) – Statement Of Admiral Thad Allen, Commandant, On The Integrated Deepwater System [PDF], Before The Subcommittee On Coast Guard And Maritime Transportation, U. S. House Of Representatives
- ICGS Deepwater (Sept 20/05) – Fast Response Cutter Achieves Successful Design Review for the U.S. Coast Guard
- USCG (June 21/05) – Adm. Thomas H. Collins, the Commandant of the U.S. Coast Guard, statement on the Integrated Deepwater System, Subcommittee on Fisheries and the Coast Guard of the US Senate’s Commerce, Science, and Transportation Committee.
- USCG (June 2/05) – Testimony: Recapitalizing Coast Guard is foundation to continued maritime security and facilitating flow of commerce
News & Views
- Chuck Hill’s CG Blog (March 23/11) – Multiple crewing for Fast Response Cutters. Hill normally hates the idea, but the pace of Island Class decommissionings vs. Sentinel Class introductions may leave this as the least bad option.
- Inside the Navy, via USCG Acquisitions Directorate (March 10/08) – Re-Analysis Validates Coast Guard’s Way Ahead With Deepwater [PDF].
- Defense Tech (Feb 15/07) – Taking on LockMart. Was Mike DeKort right? David Axe looks at the Inspector General report, and concludes that the contractor was “guilty of minor crimes,” but the biggest problem was out of their hands: “…these boats were designed to last 15 years. And they did. The Coast Guard ran into problems when it tried to keep the boats past their intended service life.”
- DID (Dec 11/06) – US Coast Guard’s Deepwater Effort Hits More Rough Sailing. Courtesy of expose articles in the NY Times and Washington Post.
- DID (Sept 20/06) – Lockheed Whistleblower Wants Congressional Investigation. Mike De Kort, quoted in the NY Times article, is the Lockheed whistleblower in question. His allegations concern the Deepwater program – and many are later vindicated.
- Military.com (Sept 13/06) – Whistleblower Calls Out Lockheed. Describes some of DeKort’s specific allegations.
- National Defense Magazine (August 2006) – Troubled Coast Guard Cutter Threatens Deepwater. Raises the possibility of an off-the-shelf purchase instead.
- DID (March 30/06) – US Government Ship-Building Roundup. Including Deepwater.
- Defense News (Sept 19/05) – New U.S. Coast Guard Cutter Gets Go-Ahead. FRC gets go-ahead approval at the Preliminary Design Review.
- DID (Aug 25/05) – Seapower: USCG Deepwater Program Special Issue
- DID (Aug 16/05) – U.S. Coast Guard’s Deepwater Acquisition Plan In Deep Water?
- Government Executive (April 15/04) – Rough Seas: The Coast Guard’s revolutionary acquisition strategy hits choppy waters.
- ICGS Deepwater (March 8/04) – ICGS Delivers First 123-Foot Cutter
- Seapower Magazine (November 1997) – Halter, Bollinger team in bid for USCG’s Deepwater cutters
